Tag Archives: #TheBotanicaApartments

Quick update on works out the front

Good news is that today they have poured the concrete where our driveway goes. Next step is waterproofing and then backfill. So all great progress.

That’s the good news…the bad news is that Chiller #1 is underway and it looks massive

Advertisement

Botanica lower car park entry / exit

A few people noticed this comment from CYP the other day …

“Next week the team will break out the previous kerb line and footpath in front of 390 St Kilda Road to prepare a temporary road surface for the re-orientation of Botanica’s St Kilda Road driveway out towards Bowen Lane. By late next week the driveway should be switched onto this new alignment. “

What does it mean? CYP are drawing some diagrams but essentially it will something like this

  • The existing St Kilda Rd past Botanica will continue as is.
  • The area in front of 390 St Kilda Rd will be ‘adjusted’ to allow a ‘driveway’ (Jan’s Way mark 2) about where the kerb is currently.
  • To access the lower cark park from the south, you will go past our building down to Bowen Lane and effectively do a U turn along the new Jan’s Way. Then right into our driveway.
  • You will also be able to come up Bowen Lane and turn right into Jan’s Way
  • On exiting the driveway, you turn left onto Jan’s Way. At Bowen Lane you will be able to turn left. You MAY be able to turn right and merge onto St Kilda Rd. Waiting on safety checks

This will occur late this week

I know that if you can only exit via Bowen Lane it means a crazy path to South Melbourne. Don’t shoot the messenger

CYP Weekly update

Good morning everyone,

I hope everyone took the opportunity to get out into yesterday’s glorious sunshine after what can only be described as a miserable week of weather.

That is a not-so-subtle segue into the impact that the rain has had on the work out on site. The team have lost a huge amount of time to the weather this week and the overnight works that have been happening last week will unfortunately need to roll into the following week.  While we recognise that this will roll directly into the 24/7 works starting on the 27th November – unfortunately it is unavoidable, as it is critical that the tram track infrastructure within the site is ready to connect into the infrastructure that we will be constructing while trams are shut down from the 27 November to the 17 December.

I’ve included a copy of the notification will go out on Monday to local residents advising of the extension to the works.

Once again the table of activities is contained below, but it is essentially the same activities that we have notified previously, but were unable to complete due to the weather.

Anzac Station entrance construction – Tram Interchange

On the station platform, the works next week will continue to be focussed on the laying of bluestone pavers. The question has been raised with the team about the planting of the new trees that will be a feature of the new tram platform. On the advice of arborists, the trees will be planted in Autumn next year rather than during the hotter summer months (after the past week of weather we’ve had this doesn’t ring true, but the advice is that the warmer months ahead will impact on the long term health of the future trees) Works on the station kiosk will also continue, with the installation of cladding around the kiosk.

On the canopy itself, the skylight flashing and final works on the architectural finishes on the underside of the canopy will all be underway next week.

Surface Works

The new track continues to make its way out from the platform to both the north and the south. Next week will see more track laid and concrete poured to the north of the tram platform, especially now that the backfill around the ventilation structures has largely been completed.

On the north-west corner of Park Street works have begun to construct the final legacy design for a kerb outstand and tram pole installation.  The future kerb line extends out further from the existing kerb and this extended kerb line is currently being constructed, along with one of the tram wire poles that will be required during for the new tram alignment.  To construct this extended kerb the left turn from Park Street into St Kilda Road has now been temporarily closed, this left turn will reopen ahead of the closure of the northbound lane of St Kilda Road to ensure access is maintained to the buildings along this section of St Kilda Road.

Station box construction

Underground, the team have completed both the eastern and western sections of track slab adjacent to the new tram platform. On the platform itself, we’ll be pouring the concrete for the wearing slab of the platform, while also continuing with our steelwork in preparation for the future platform screen doors. Escalators 1 and 2 are being installed next week, these sit adjacent to the freshly poured stairs linking the concourse level to the platform.

Shrine Entrance

The Shrine entrance continues to work away over in the corner of the site – installation of formwork is ongoing next week as is the steel fixing for the capping beam on top of the piles, this all ahead of the final stage of excavation, which is expected to commence in early December.

Extended Hours Works:

The works listed below are those that will extend overnight next week. At this stage of the program, all these works are likely to extend for the duration of the week.

If the noise is an issue…

If you are having issues with the noise outside during the nights – call 1800 105 105.

They will entertain relocations if needed as a last resort.

You may have also noticed that they cannot work if there is any rain….so you could take matters into your own hands and use one of these TOY water pistols. I doubt they can tell the difference between rain and water from this.

They are available here

What are those vents used for???

  • The round one is an inlet – It brings in outside air to the mechanical systems, so nothing will be discharged from it.
  • The middle one is an outlet – It is the over track exhaust, but also has battery/uninterruptable power supply (UPS) room exhaust in the event they are called on. During normal operations, the over track exhaust extracts heat locally from the air conditioner condensers which are onboard the train and braking devices of the stationary trains. In the unlikely event of a fire, this would be used to extract smoke from the trackway, platform and concourse.
  • The tall one is a tunnel ventilation system (TVS) inlet exhaust –The TVS shaft can either exhaust or supply depending on the requirements of the tunnel (two shafts – one supply and one exhaust). The TVS is an environmental control e.g provide fresh air within tunnel and discharges oncoming air from approaching trains. In the unlikely event of a fire, the TVS is designed to prevent smoke spreading and to maintain acceptable conditions in the non-incident tunnel.

CYP update

Good evening everyone,

Apologies for the delayed look ahead. It appears this didn’t send properly on Friday afternoon – with any luck this one arrives in your inboxes.

There has been a lot of change out on site recently with the site now divided by the new section of southbound lane of St Kilda Road. This has allowed the us to shift our barriers onto what was the previous southbound lane and begin to breakout the old traffic lane to lay new tram tracks and lay the new road alignment adjacent to these tracks. Thankyou to everyone for you patience as we tied in the new section of the road, the significant amount of rain did not help matters, but the new lane is now open and we’re pushing ahead.

Next week will see a number of key activities run up until 10pm – During the week just gone, we wrapped up activities at 8pm, but the weather is not looking kind, and it is more than likely that these will need to continue all the way until 10pm.

Anzac Station entrance construction – Tram Interchange

The footprint of the new tram interchange will begin to expand significantly over the next few weeks as the team begin to pour the concrete foundations of the platform itself. The platform extends from just near the top of Albert Road, all the way down beyond the new kiosk that has been constructed and is now in the process of being fitted out. The team are also getting up underneath the canopy to get some works done on the underside of the canopy, while at ground level, the first sections of glass for the balustrades around the oculus began to be installed this week and will continue into next week.

Next week will also see more progress on the kiosk, with the glass installed for the future kiosk and the installation off some of the cladding around the outside of the kiosk.

Some of these works will continue out to 10pm including works on the underside of the canopy and the installation of the new cladding on the kiosk.

Surface Works

Outside the platform, the new sections of tram tracks continue their progress through site on the eastern side. Now that we’ve taken the old southbound lane of St Kilda Road and made some room on the western side of the canopy, you’ll start to see more tram track work in this section as well as installation of the new tram poles.  We are quickly approaching the deadline of the 27 November, when we switch off the power to the tram lines, buses replace trams and we begin the 24/7 works to break out the existing tracks and realign them to connect in with the new sections of tram alignment around the new platform.  Like this week, next week some activities will extend out to 10pm to ensure we are ready for the 27 November.  The platform and new sections of track need to be ready for this critical date, so over the coming weeks more activities will extend out to 10pm.  Activities you’ll see on site next week are similar to those you’ve seen to date, with excavators doing earthworks, tram track laying, asphalting, concrete pours.

The ventilation shafts will also continue to get some attention next week, the concrete pours continuing for the northern shafts are complete, connecting them to the station roof. We’ll see same at the southern end next week before waterproofing and backfill commences on both.

Station box construction

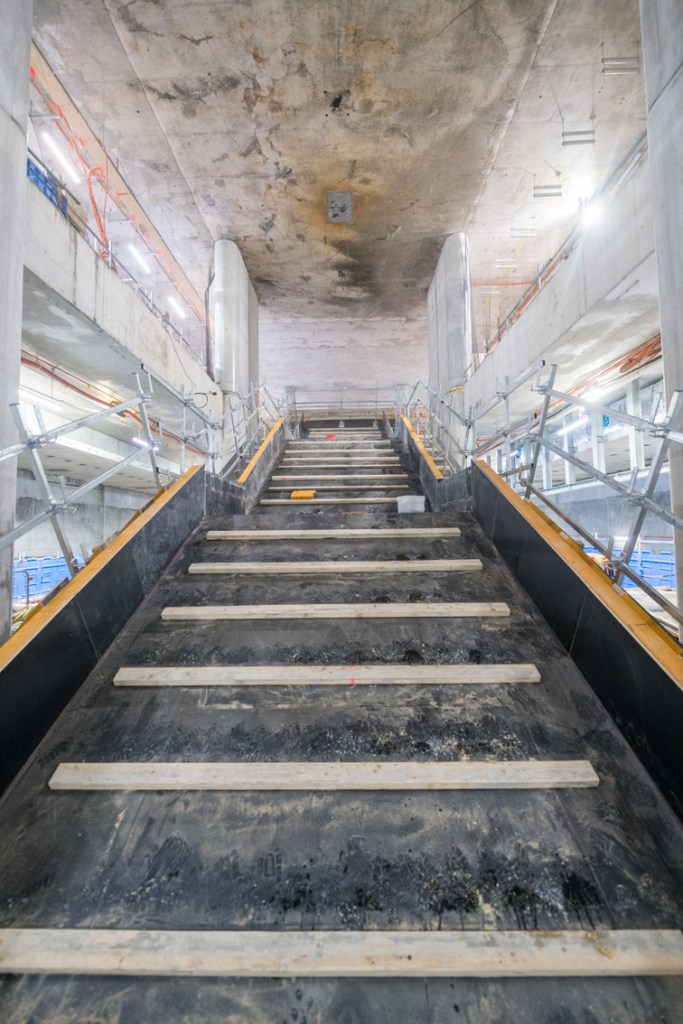

The big development inside the station box is the start of the construction of the stairs from concourse level down to platform level. The frame for the future pedestrian elevator has also been installed. We’ve included a photo this week on the first section of the formwork for the new stairs.

Shrine Entrance

Next week at the Shrine entrance over near Domain Road will see the start of the steel fixing for the new section of roof. Once the roof is installed, the main excavation down to the future base slab will commence.

Regards, Rob and Christian
